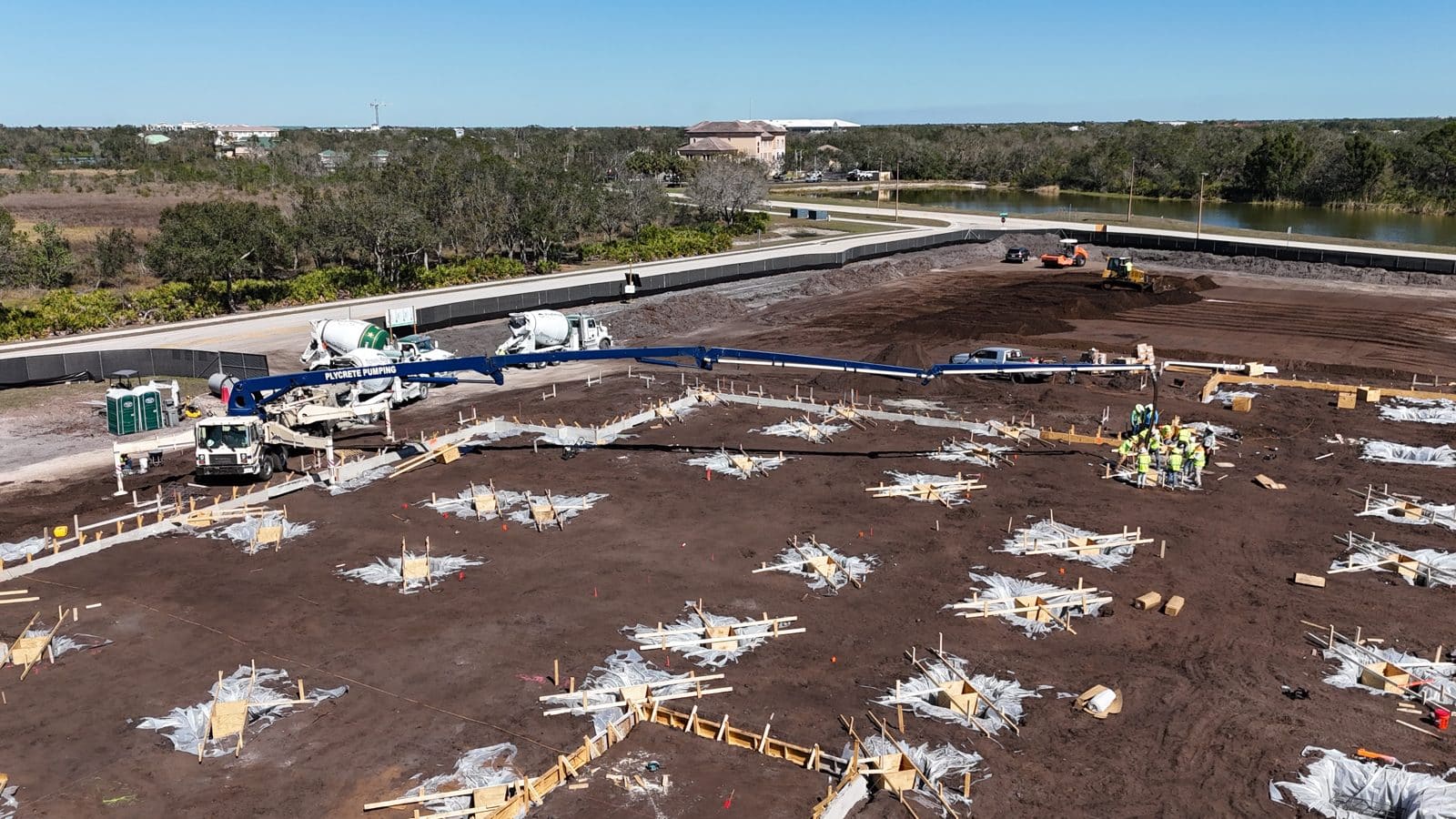

Concrete pump access planning should begin while the project team can still change traffic routes, staging areas, and the placement sequence. Waiting until pour day can leave a pump, ready-mix trucks, workers, and other trades competing for limited space. A useful plan identifies the intended equipment area, the route serving it, known site constraints, work-zone boundaries, and the people responsible for final safety decisions. Because equipment and sites differ, this overview focuses on coordination questions. It does not provide operating clearances or replace the pump provider’s requirements, the site-specific safety plan, or competent-person review.
Choose an Equipment Area From Actual Site Information
The preferred pump position should support the planned placement while remaining practical for delivery trucks and the rest of the site. Review the latest site plan, grading, excavations, utilities, overhead features, property boundaries, occupied buildings, public roads, and construction phasing. A location that looks open on an early plan may later contain stored materials, active trenches, curbs, landscaping, or another contractor’s equipment.
Ground conditions need project-specific evaluation. The team should identify filled areas, soft shoulders, vaults, utility structures, slopes, and edges. The pump provider and responsible site personnel should determine whether the proposed position and support conditions meet equipment and safety requirements. Do not assume that a paved-looking surface can carry any configuration.
The selected area should also fit the concrete placement sequence. Hose or boom reach, relocation needs, and access to different placement zones must be reviewed by qualified personnel using the actual equipment information. When a single location will not serve the planned work, build any repositioning into the schedule and traffic plan.
For projects that are still being scoped, the Southwest Structural Inc concrete services page provides a starting point for discussing the placement and related concrete work. Equipment selection and setup remain specific to the accepted project.
Map the Ready-Mix Route and Truck Rotation
The pump is only one part of the operation. Ready-mix trucks need a defined way to enter, approach, discharge, and leave without backing into unmanaged traffic or blocking emergency access. Review gate widths, turns, grades, overhead conditions, internal roads, public interfaces, and locations where pedestrians or other crews cross the route.
A route should account for the whole day, not just the first delivery. Ask whether deliveries from other trades will use the same entrance, whether school or commuter traffic affects the public road, and whether earlier weather could change unpaved surfaces. Establish who controls the gate and truck movement and how that person communicates with the placement crew.
- Mark the approved entrance, exit, and internal travel path.
- Identify turning and waiting areas without assuming trucks may stage on a public road.
- Separate pedestrian routes and occupied areas from truck movement.
- Keep emergency and fire access available as required by the site plan.
- Define the washout and cleanup procedure before deliveries begin.
The National Ready Mixed Concrete Association offers project education through its technical and Pave Ahead resources. Use the exact guidance that applies to the project, supplier, and placement rather than relying on a generic rule.
Coordinate Overhead, Below-Grade, and Public Constraints
Overhead lines, structures, trees, cranes, and temporary installations can affect the proposed work area. Below-grade utilities, chambers, septic components, culverts, excavations, and recently backfilled trenches may not be obvious during a quick walk. The site team should compare current records with field conditions and involve the responsible utility or safety personnel when required.
Public protection deserves deliberate planning. A placement near a sidewalk, roadway, occupied facility, or neighboring property may require barriers, traffic control, access coordination, or local approvals. The project team should determine those needs through the applicable authority and project safety process. A contractor should not improvise traffic control from an online checklist.
South Florida sites also need weather contingencies. Heavy rain can change access conditions and affect areas that were previously firm. Lightning can interrupt an operation. The team should identify who monitors conditions and who can pause or revise the work. If the equipment position becomes unsuitable, the contingency plan should favor a controlled decision over an unreviewed relocation.
Run a Final Logistics Review Before Placement
A useful final review is a site walk involving the people who understand the current construction conditions and the proposed equipment. Confirm the planned placement limits, pump position, delivery route, work-zone boundaries, communications, testing access, washout location, lighting when needed, and contingency decisions. Record open items and assign them to named parties.
Confirm that the site plan matches reality. Construction sites change daily. Stored reinforcement, dumpsters, lifts, parked vehicles, temporary fencing, and excavations can alter the route after the original plan was approved. The superintendent should ensure that the agreed areas are cleared and controlled before equipment arrives.
Communications should be simple and specific. Identify the main site contact, the person directing truck flow, and the party communicating with the supplier. Decide how delays or changed conditions will be reported. A shared plan helps prevent different crews from making conflicting decisions under schedule pressure.
Finally, review post-placement movement. Truck departure, pump breakdown or cleanup, curing operations, barricades, and other site traffic continue after concrete discharge ends. The logistics plan should carry through until the work zone is safely returned to the project.
Large or phased projects should revisit the plan for each placement. A route that worked for an early foundation pour may be unavailable after walls, curbs, utilities, or landscaping are installed. Likewise, the most useful pump position may change when the placement moves to another side of the building. Treat the approved plan as current information, not a permanent site assumption.
Include specialty access requirements in the bid and coordination documents when they are known. Restricted working hours, gated-community procedures, facility escorts, roadway permits, security clearances, or owner rules can affect mobilization. Early disclosure lets each bidder state assumptions and keeps access conditions from becoming a surprise after the schedule is set.
Document the reviewed arrangement with a simple marked plan or logistics sketch approved through the project’s process. Show the intended equipment area, vehicle route, controlled work zone, washout location, and key restrictions. The sketch should be updated when conditions change and should never be treated as an equipment-engineering drawing unless it was prepared and approved for that purpose.
Frequently Asked Questions
Can the pump always set up next to the placement?
No. Equipment capability, ground conditions, overhead and below-grade constraints, access, and the site safety plan determine acceptable positioning. The pump provider and responsible site personnel must review the actual location.
Who should direct ready-mix trucks on site?
The project should assign trained site personnel under its traffic and safety procedures. The role and communication method should be clear before deliveries start.
What if rain changes the access route?
Stop and reassess the conditions through the project’s decision process. Do not assume that a route remains suitable because it worked previously or looked firm during an earlier inspection.
Should pump access be included with a bid request?
Yes. Include the current site plan, known restrictions, placement area, proposed access, construction phase, and any owner or facility rules. That information helps contractors state assumptions and identify questions.
For a South Florida concrete project that may require coordinated pumping and delivery logistics, contact Southwest Structural Inc or call (239) 410-3943. Share the current drawings, placement limits, project address, and known access constraints so the team can discuss the scope.
